Hanoi MICE Venue Capacity Guide for Planners (2026)

Hanoi MICE Venue Capacity Guide for Planners (2026)

Reading time: 35-45 min

This Hanoi MICE venues capacity guide is written for decision-stage MICE planners who need verified room capacities, production constraints, and AV realities - not marketing brochures. It focuses on what you can confidently put into an RFP response, a stakeholder deck, or a client-facing venue recommendation for 200-1,000 pax programs in Hanoi (2026 planning).

Key point upfront: across JW Marriott Hanoi, Lotte Hotel Hanoi, and Melia Hanoi, JW Marriott Hanoi is the only venue with consistently published, cross-referenced capacity-by-setup data in current trade sources. For Lotte and Melia, you should treat capacities and AV feasibility as RFP-required until the hotel provides written confirmation (preferably with diagrams and a draft BEO). This approach reduces re-routing risk, fire-code exposure, and last-minute production re-design.

If you are building your operational plan now, pair this article with our routing playbooks: Hanoi group routing playbook and hotel access and coach logistics playbook. They are designed to turn venue specs into coach call times, loading sequences, and a run-of-show that survives Q4 congestion.

Dong DMC operations desk coordinating multi-coach arrivals and venue check-in windows for a corporate event in Hanoi
Decision-stage planning is about control: arrival waves, coach slots, and check-in throughput are planned before creative elements are locked.

Planning Takeaways

  • Use JW Marriott Hanoi as the verified benchmark - published capacities include Grand Ballroom: 950 theater / 700 banquet / 540 classroom with 7m ceiling height, making it the safest choice for 200-1,000 pax proposals where capacity must be defensible.
  • Plan Q4 (Oct-Dec) like a constrained supply market - for ballroom-heavy programs, set a 6-12 month lead time expectation to avoid forced compromises on breakouts, setup windows, and AV labor availability.
  • Allocate a real production buffer - for LED wall + truss + line checks, assume 4-6 hours ballroom setup at JW. Put this into your stakeholder schedule early to prevent day-of delays.
  • Control risk with real-time visibility - combine badge printing and check-in counts, session scanning, push/SMS schedule broadcasting, and live budget approval workflows to prevent the three common failures: unknown attendee status, missed schedule changes, and late budget surprises.

1) Planner context for a Hanoi MICE venues capacity guide (2026 decision-stage)

Why Hanoi is operationally chosen for regional conferences: Hanoi continues to win corporate and association demand in Asia because it functions as Vietnam's political and administrative hub. For planners, that translates into a predictable pattern: higher VIP sensitivity, more last-minute delegate list updates, and stronger expectations for access control and protocol compliance. Programs tied to government-adjacent industries (manufacturing, infrastructure, finance, technology) often prioritize Hanoi for meetings where attendance certainty and security posture matter more than leisure add-ons.

What this means for venue pressure: demand surges concentrate around business peak windows, with Q4 (Oct-Dec) typically compressing sourcing timelines. Under compression, the first compromises you see are not room rates - they are breakout availability, pre-function circulation, and production windows. In other words, you can still "book a ballroom" late, but you may lose the hours and adjacent spaces that make the ballroom usable for a high-production show.

Lead time reality you can put in front of stakeholders: for 200-1,000 pax programs in Hanoi using a primary ballroom plus multiple breakouts, assume 6-12 months to hold the correct pattern of space. This is not a preference - it is the practical way to avoid late-stage re-design (splitting plenaries, reducing expo pods, or cutting rehearsal time).

Data availability matters in the decision stage: JW Marriott Hanoi has the most consistently published capacity and room inventory detail across trade sources. In contrast, current public sources do not provide reliable, pax-by-setup confirmation for Lotte Hotel Hanoi or Melia Hanoi. For a decision-stage buyer, that means:

  • JW Marriott can be presented to clients with defensible capacity math and initial routing logic.
  • Lotte and Melia can be shortlisted, but should be framed as "pending written capacity and AV feasibility confirmation" until diagrams, ceiling heights, loading route, and internet policy are confirmed in writing.

Capacity-driven segmentation you can use in proposals:

200-400 pax - single ballroom (or large function room) plus 4-8 breakouts. Success factor: pre-function width and registration throughput.

400-700 pax - ballroom plus meaningful pre-function for sponsor pods and coffee breaks; staging and rigging requirements become first-class constraints.

700-1,000 pax - JW Marriott Hanoi is the simplest single-hotel option with published capacities. For additional scale or expo-heavy programs, plan an overflow or hybrid model with National Convention Center (NCC) as a second site.

Operational references used for this guide include trade venue listings and meeting space data for JW Marriott Hanoi and broader Hanoi MICE market context. Where Lotte or Melia data is missing from public sources, this article provides the exact RFP questions required to close the gaps before contracting.

2) Practical planning guidance: venue fit, program architecture, and decision tools

In Hanoi, venue selection should be treated as an operational decision first, and a brand decision second. The decision-stage criteria below are designed to prevent three common failures: (1) choosing a room that cannot physically take the production build, (2) under-allocating circulation and causing schedule slip, and (3) committing to a venue before internet and AV policies are contractually clear.

2.1 Match venue selection to program type (what must be true)

Use this as a proposal-ready fit checklist. If a venue cannot confirm these items in writing, treat it as a sourcing risk.

Conference (plenary + breakouts): pillar-free plenary room (or acceptable sightline plan), ceiling height suitable for screens/lighting, breakouts on the same level where possible, and enough pre-function square meters to prevent choke points during coffee breaks.

Awards gala (high-production banquet): verified banquet capacity with staging footprint included, rigging/power confirmation, late-night load-out policy, and a realistic rehearsal window that does not collide with guest traffic.

Product launch (press + demo zones): controlled loading route, sponsor/demo power distribution, and stable connectivity in stage, FOH, and press corner.

Hybrid summit: internet SLA (not just "Wi-Fi available"), support for video conference workflows, and a pre-scheduled technical rehearsal with venue and AV stakeholders.

2.2 A fast shortlisting tool using the Hanoi MICE venues capacity guide lens

When time is tight, shortlist using five checks. These are the checks that keep your plan stable after stakeholder changes and production upgrades.

  1. Capacity verification: get pax-by-setup tables (theater, classroom, banquet, cabaret, reception) and confirm if numbers assume staging, buffet lines, camera platforms, or center aisles.
  2. AV rider acceptance: confirm whether outside AV is allowed, whether in-house AV is mandatory, and what deadlines apply for rigging plans and technical drawings.
  3. Internet policy: confirm tiers, pricing model (per device vs per Mbps vs per day), wired options at stage/FOH, and whether additional fees apply for dedicated bandwidth.
  4. Setup and rehearsal windows: lock the 4-6 hour setup buffer for high-production ballrooms (JW reference) and protect a rehearsal slot.
  5. Overflow option: confirm whether a second site is feasible (NCC pairing) and what shuttle timing looks like under peak traffic.

If you need a detailed operational approach to routing, coach slots, and hotel access constraints, reference our traffic and protocol risks playbook and the hotel access and coach logistics playbook.

2.3 Program architecture templates (proposal-friendly, not an itinerary)

These templates are intentionally generic so you can adapt them to JW, Lotte, or Melia while keeping the operational logic consistent.

Template A: Plenary + 6-10 breakouts + expo pods

  • Registration and badge printing at pre-function entry (two-sided flow: entry and exit lanes).
  • Plenary ballroom with a defined FOH corridor and dedicated speaker ready room.
  • Breakout cluster with buffer corridors to prevent session changeover congestion.
  • Expo pods in pre-function or exhibit space with power map and sponsor load-in slots.

Template B: General session + evening gala + morning workshops

  • Daytime plenary layout optimized for sightlines and note-taking (theater/classroom as required).
  • Gala reset plan that protects production build time and avoids crossing with guest movement.
  • Morning workshops using smaller rooms with controlled start times to reduce lift congestion.

Template C: Hybrid summit with remote speakers + press corner

  • Dedicated wired internet at stage and FOH; backup network plan (secondary line or bonded uplink via supplier).
  • Remote speaker green room (quiet, controlled lighting, tested audio path).
  • Press corner with separate power and bandwidth allocation to prevent audience Wi-Fi draw affecting stream stability.

2.4 What to request from Lotte Hanoi and Melia Hanoi in the RFP (to close public data gaps)

Because Lotte and Melia capacities and AV constraints are not consistently published in current trade sources, an RFP must pull the missing data in a format you can contract against. Include the items below verbatim to reduce ambiguity.

Required capacity and diagram package (by room):

  • Max pax by setup: theater, classroom, banquet (10 per table), cabaret, reception, U-shape, boardroom.
  • Room dimensions, total sqm, ceiling height, and pillar locations (if any).
  • Stage location options and how staging reduces seated capacity.
  • Foyer/pre-function sqm and whether it can host sponsor pods.

Production feasibility (AV and rigging):

  • Rigging points map, maximum load per point, and rigging approval lead time.
  • Power availability: phase, amperage, distribution points, and whether a generator is required for large builds.
  • Outside AV policy: permitted vendors, in-house exclusivity, technician staffing rules, and overtime rates.
  • Technical rehearsal policy and minimum booking hours.

Access and loading (non-negotiable for 200+ pax):

  • Loading dock dimensions, freight elevator size, and back-of-house route to ballroom.
  • Coach parking count, coach drop-off sequence, and whether engines can idle during hot load-in.
  • Storage policy for cases and crates during show days.

Internet and connectivity (SLA-oriented):

  • Internet tiers (shared vs dedicated), pricing, and whether dedicated bandwidth is guaranteed.
  • Wired line availability at stage and FOH, plus backup options.
  • Support model: who is on-call during show hours and target incident response time.

If the hotel cannot deliver the above within your bid timeline, keep it on the list as a future option, but do not position it as the primary venue for a high-stakes program. This is how planners protect stakeholder confidence and prevent rework.

2.1 JW Marriott Hanoi (2026-ready): verified capacities and space planning you can quote

JW Marriott Hanoi is the most defensible option in this shortlist because its meeting space inventory and capacities are consistently referenced in trade sources. For decision-stage proposals, this reduces your risk of over-promising a setup that the room cannot support.

Verified meeting inventory highlights (planning-grade):

  • 17 meeting rooms (trade sources cite a range of 13-17; assume 17 and confirm in your BEO draft).
  • 5,000+ sqm total meeting space.
  • 2,400 sqm exhibit space and approximately 2,600 sqm pre-function circulation (useful for registration, sponsor pods, and coffee breaks).
  • Outdoor overflow potential via gardens (reported around 1,200 sqm - confirm layout, noise policy, and weather plan).

Location and access constraints you should build into routing: JW Marriott Hanoi is at 8 Do Duc Duc Road, Nam Tu Liem (west of central Hanoi). Airport transfers from Noi Bai are typically 30-45 minutes depending on traffic. Peak congestion on Pham Hung corridor is a known variable, so coach call times should include buffers and staggered waves for 20+ coach programs.

Badge printing and check-in lanes being configured for a 600-pax conference with real-time attendance dashboard
Throughput is a capacity issue: lane count, badge printing, and scanning determine whether your plenary starts on time.

2.1.1 JW Marriott Hanoi pax-by-setup highlights (decision-stage numbers)

Use the following figures when you need to justify feasibility to stakeholders. These are the figures most planners need for routing math and sign-off.

Grand Ballroom (full) - 1,000 sqm, 7m ceiling height

  • 950 theater
  • 540 classroom
  • 700 banquet
  • 900 cabaret-reception (trade listing language varies; confirm your exact cabaret spec and aisle plan)

Fansipan Ballroom - 480 sqm, 7m ceiling height

  • 450 theater
  • 210 classroom
  • 300 banquet
  • 450 reception

Grand I / Grand III (section) - 363 sqm, 7m ceiling height

  • 260 theater
  • 168 classroom
  • 200 banquet
  • 300 reception
  • 72 U-shape

Fansipan I / Fansipan II (section) - 185 sqm, 7m ceiling height

  • 150 theater
  • 45 classroom (confirm this figure in your BEO draft, as classroom counts are highly table-size dependent)
  • 100 banquet
  • 150 reception
  • 33 U-shape

Example breakout sizing

  • Song series rooms 39-55 sqm: typically 12 boardroom
  • Ho Tay (example) 110 sqm, 6.5m height: 70 theater (and up to 120 reception depending on furniture plan)

AV and room traits that impact production planning: JW lists in-house AV support, high-speed and wireless internet (often fee-based), and video conference capability. Note that main ballrooms are typically no daylight, which is not a negative operationally but does require a deliberate lighting plan if you have camera capture, press photography, or brand color accuracy requirements.

2.1.2 Space-to-flow guidance (how to reduce delays and cross-traffic)

Capacities alone do not prevent schedule slip. The most common cause of late starts at 400-1,000 pax scale is cross-traffic created by registration, coffee service, and sponsor zones placed in the wrong sequence.

Routing logic that works reliably at JW (transferable to other venues):

  • Registration: place check-in at the widest pre-function entry, with separate lanes for pre-registered delegates vs on-site changes. Ensure a buffer zone before ballroom doors to avoid backflow.
  • Speaker-ready and VIP holding: keep it off the main pre-function corridor. This prevents speaker delays caused by crowd density and reduces privacy risk.
  • Breakouts: cluster sessions by audience type and stagger end times by 5-10 minutes where possible. This is more effective than adding staff when the corridor is physically constrained.
  • Coffee breaks: distribute stations across pre-function length, not in a single line. Single-line buffet layouts create time loss and force late plenary re-entry.
  • Sponsor pods: allocate zones that do not block ballroom door swing paths. Door congestion is a primary safety and punctuality risk.

Decision-stage confirmation you should request from JW during the first technical call: exact loading route and dock-to-ballroom timing, internet tier pricing for dedicated bandwidth, and AV labor policy for extended rehearsal hours. This is where hidden costs and timing constraints usually appear.

2.2 Lotte Hotel Hanoi and Melia Hanoi: how to evaluate when capacities are not publicly verified

Lotte and Melia are frequently considered in Hanoi shortlists due to brand recognition and central accessibility. However, for decision-stage planning, the issue is not whether they can host events - it is whether you can contract against verified capacities and AV constraints without ambiguity. Current public trade sources do not provide consistent pax-by-setup capacity tables and AV specifics for these two venues in the same way they do for JW Marriott Hanoi.

Planner-safe approach (recommended):

  • Position Lotte and Melia as candidate venues pending written confirmation of capacities, ceiling height, and loading route.
  • Do not finalize program flow, sponsorship zoning, or production design until you receive diagrams and a draft BEO timeline.
  • Make your internal stakeholder recommendation conditional: "Subject to confirmation of rigging points, internet SLA, and coach logistics."

Site inspection questions that mirror the JW benchmark (use these verbatim):

  • Ballroom: Is it pillar-free? If not, provide a sightline plan for theater and banquet with stage.
  • Ceiling height: Provide measured height in meters and any hanging restrictions.
  • Rigging: Provide rigging points map, max loads, and approval lead time.
  • Loading route: Show dock, freight elevator dimensions, corridor turns, and door widths to ballroom.
  • Coach parking: Confirm coach count, drop-off flow, and holding area policy.
  • Power: Confirm distribution points, phase, and any generator requirements for large LED walls.
  • Internet: Provide rate card and whether dedicated bandwidth is available with SLA and on-site support.
  • Noise bleed: Confirm acoustic separation between ballroom and adjacent rooms during simultaneous sessions.
  • Rehearsal: Can you lock a live technical rehearsal? What is the technician overtime model?

Decision criteria for 2026 sourcing: in competitive bids, the venue that wins is often the one that behaves operationally like a partner - fast, transparent, and willing to test. Score Lotte and Melia on: responsiveness to AV rider, transparency on fees (Wi-Fi, rigging, technician hours), and whether they will commit to a timed technical rehearsal with sign-off checkpoints.

If you want a framework for how we validate this information before you commit to a client-facing promise, review why partners choose Dong DMC and how we operate under white-label conditions.

2.3 Overflow and hybrid setups with National Convention Center (NCC): when and how to pair with JW Marriott

For programs that are too large, too expo-heavy, or too sensitive to single-point failure, pairing JW Marriott Hanoi with the National Convention Center (NCC) creates operational redundancy. NCC is cited as a large-scale venue option (up to 3,800 pax in referenced market context). The pairing is practical because of proximity (typically cited as a short drive), enabling shuttle routing without city-center crossings.

When the two-venue model is justified (stakeholder-friendly logic):

  • Plenary overflow: main ballroom plenary at JW with streamed overflow rooms or a secondary plenary at NCC for additional delegates.
  • Expo expansion: conference at JW, exhibit-heavy component at NCC, keeping high-traffic movement away from hotel guest areas.
  • Multi-stream congress: concurrent tracks split by audience type, reducing noise bleed and corridor congestion.

Simple two-venue routing model (operationally realistic):

  • Shuttles: fixed loop with departure every 8-12 minutes during peak transfer windows; stagger by session end times.
  • Badge access: single credential across both venues with scan points at entries to maintain real-time attendee status.
  • Communication: schedule updates pushed instantly via event app plus SMS fallback for critical changes (venue change, session delay, gate update).
  • Operational control: one command center responsible for time-stamped run-sheet updates across both sites.

Client-facing value statement (proposal-ready): "The two-venue model reduces risk by separating high-traffic expo movement from hotel operations, while maintaining schedule control through unified badge scanning, real-time attendance counts, and push/SMS schedule broadcasting."

3) Operational excellence and risk management (zero-surprise execution)

Venue specifications only matter when they are converted into a runbook with owners, deadlines, and measurable checkpoints. For high-stakes programs in Hanoi, the failure modes are consistent: production setup takes longer than planned, arrivals bunch due to traffic, Wi-Fi and AV charges appear late, and schedule changes fail to reach all attendees. The controls below are designed to prevent those outcomes.

3.1 Runbook structure: what must exist before show week

A decision-stage operational plan should include these components. They can be forwarded to a client as proof of governance.

  • Master schedule: show days + build days + rehearsal windows, with dependencies.
  • Critical path: items that, if late, delay opening (internet activation, rigging approval, stage build completion, line check, content upload).
  • Ownership map: who signs off each milestone (planner vs DMC vs venue vs AV vs security).
  • Load-in/load-out plan: dock booking, freight elevator windows, case storage, and corridor protection.
  • Escalation paths: named contacts and decision rights for budget approvals and schedule changes.

3.2 Hanoi logistics reality: transfer buffers that protect on-time starts

For JW Marriott Hanoi, plan airport transfers at 30-45 minutes under typical conditions, with increased variability during peaks. In practice, planners should build buffers into call times and avoid stacking critical activities immediately after airport arrival. Two controls reduce risk most:

  • Staggered arrival waves: distribute arrivals by flight blocks and delegate type (VIP, speakers, general delegates). Do not send 20+ coaches into one drop-off window.
  • Hard cut-off for plenary entry: a defined last call time, communicated via app/SMS and reinforced by floor teams, protects your opening segment.

For coach-heavy programs, use our operational routing references: hotel access and coach logistics playbook and traffic and protocol risks playbook.

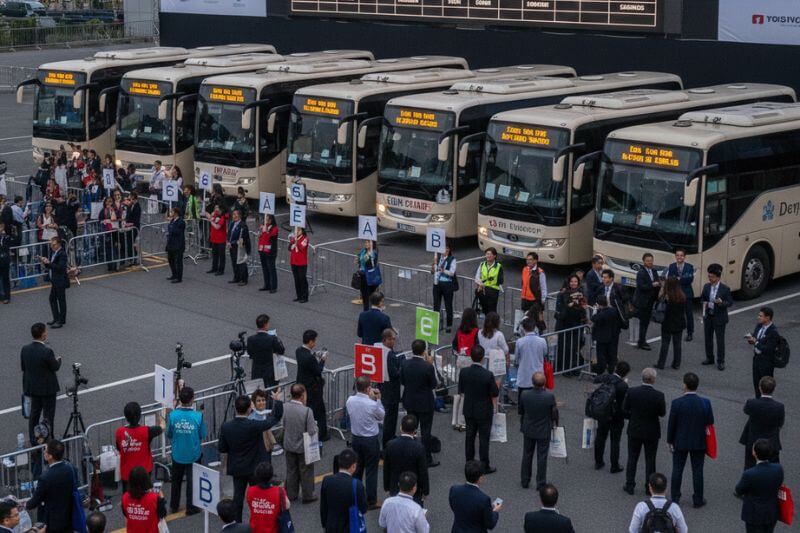

Multi-coach staging plan with timed departure board and zone leads coordinating delegate movement for a 500-pax corporate program
A coach plan is a schedule protection tool: staging zones, radio calls, and timed release prevent venue frontage congestion.

3.3 Cost control: preventing AV and internet surprises (decision-stage budgeting)

The most common budget shock items in Hanoi ballroom programs are AV labor, rigging, and internet. Trade sources indicate meeting package pricing and room rates that may not reflect 2026 inflation, so planners should use a governance approach rather than a single number.

Recommended controls you can write into your internal process:

  • Contingency allocation: budget an additional +10% on AV/internet lines until the final rate card and bandwidth plan are approved.
  • Approval gates: define who can approve added bandwidth, extra technicians, overtime, and late-night load-out.
  • Fee transparency: require AV and internet rate cards before contract signature or make them contractual appendices.
  • Q4 uplift expectation: plan for 20-30% peak uplift scenarios in high-demand windows and validate with written quotes.

If you need a structured approach to supplier confirmation and time-stamped approvals, our operations model is designed for brand-protected delivery. This is also where our Dong DMC Agent App supports operational visibility across suppliers and milestones.

3.1 Load-in, staging, rigging, and setup buffers (JW-focused, transferable framework)

For high-production ballrooms, the difference between a stable event and a chaotic one is almost always time allocation. JW Marriott Hanoi is cited with ballrooms featuring 6.5-7m ceiling heights, enabling complex builds, but also increasing the need for structured rigging, safety checks, and line testing.

Minimum setup buffer to protect your schedule: allocate 4-6 hours for ballroom setup when your build includes truss/rigging, LED wall, camera platforms, or significant audio deployment.

What the 4-6 hour buffer actually contains (use this to justify time blocks):

  • Rigging and truss: hang points, motors, safety cables, and sign-off.
  • Stage build: stage deck, stairs, skirting, and backstage masking.
  • LED wall and content line-up: panel alignment, processor setup, backup feed, and content format validation.
  • Audio deployment: speaker hang or stands, RF coordination for microphones, and line checks.
  • Lighting focus: key, wash, presenter specials, and camera-safe settings if filming.
  • Seating reset: final layout to match fire-code aisles and camera sightlines.

Rigging and power checks (decision-stage questions):

  • What is the approved rigging method and who must sign off?
  • What is the maximum power draw supported for a 900+ pax production environment?
  • Where are distribution points relative to stage and FOH, and what cable runs are allowed?
  • Is there a back-up power plan for critical show elements (audio, show control, streaming)?

First-in / last-out scheduling (prevents guest-traffic conflict): for events inside an operating hotel, schedule production teams as first access of the day and last exit of the night, with clear dock windows and corridor protection. This reduces collision risk with guest check-in peaks and minimizes noise complaints that can force on-the-fly changes.

3.2 Technology for real-time visibility and control (fear reducers for high-stakes planners)

Most event failures are information failures. Planners lose confidence when they cannot see attendee status in real time, when schedule changes do not reach everyone, or when budget overruns surface too late to control. A 2026-ready Hanoi program should be designed with a simple principle: if it affects time, safety, or budget, it must be visible live.

Recommended event-tech capabilities (what to specify, not what to brand)

  • Badge printing and on-site check-in: live attendance counts by time block, with instant visibility into no-shows and walk-ins.
  • Session scanning: room capacity monitoring to prevent fire-code breaches and to manage overflow decisions early.
  • Schedule broadcasting: push notifications plus SMS fallback for critical updates (room change, start delay, shuttle gate change).
  • Real-time run sheet: time-stamped updates visible to planner, DMC, venue, and AV stakeholders with role-based access.
  • Live budget tracker: approval workflows for variable-cost lines (bandwidth upgrades, additional technicians, overtime).
  • Supplier confirmation automation: time-stamped confirmations for transport, staffing, AV, print, and F&B milestones to reduce "assumed yes" risk.

Where connectivity matters most (and must be tested):

  • Registration: check-in stability determines throughput and on-time plenary starts.
  • Main ballroom stage + FOH: streaming, show control, and content playback require predictable bandwidth and low-latency reliability.
  • Speaker-ready room: last-minute content transfers and remote speaker connections are common failure points.

Connectivity testing protocol (site visit requirement): test internet with the same device count and usage pattern you expect on show day, not a single laptop speed test. Validate whether dedicated bandwidth is required and price it early. Where Wi-Fi is fee-based (as commonly listed), lock the model (per-device vs per-Mbps) before final budget sign-off.

Post-event analytics clients typically expect (and how to deliver quickly)

If your client requires measurable outcomes, plan data capture upfront. A standard reporting pack can include:

  • Attendance vs invite list: check-in totals, late arrivals, no-show percentage.
  • Session popularity: scans per session, capacity utilization, overflow counts.
  • Sponsor zone engagement: dwell time indicators where scanning or beaconing is used (only if client approves).
  • Service recovery log: incident list, time to closure, and corrective actions.

For partners who require a single operational view across suppliers and milestones, this is where our Dong DMC Agent App supports live coordination and post-event reporting efficiency.

3.3 Risk controls specific to Hanoi venue operations (what to standardize)

Hanoi has predictable operational risks that can be managed with standard protocols. The goal is not to eliminate change - it is to prevent change from becoming visible chaos.

Traffic and coach coordination (20+ coach programs)

When you scale beyond 20 coaches, the risk is not only traffic - it is frontage congestion and delayed unloading. Standardize:

  • Staggered coach release: assign waves with fixed drop-off minutes and a holding area plan.
  • Dedicated loading sequence: the order of coaches is planned and enforced by zone leads (not decided by drivers on arrival).
  • VIP separation: separate VIP arrivals from general delegate arrivals to prevent security bottlenecks.

Weather and airport reliability buffers

Seasonal fog can affect airport operations. For high-stakes opening segments, add approximately 1 hour buffer on critical arrivals and protect opening content so it can start without key speakers if needed (for example: opening video, host segment, or internal keynote first).

Safety, security, and access control

Decision-stage security planning should include:

  • Access control points: badge scanning at key entries (ballroom, VIP zones, press corner).
  • Emergency response briefing: joint briefing with venue security and your floor leads.
  • Back-of-house restrictions: controlled access to loading routes during show hours.

Contractual safeguards that prevent day-of disputes

  • AV rider acceptance deadline: for major builds, push for a deadline around 6 months out (or as early as your production schedule allows) to protect rigging approval and vendor availability.
  • Written confirmation of no-daylight ballrooms (if applicable): ensures lighting plan is budgeted and approved.
  • Attrition and cancellation clarity: align with realistic delegate confirmation timelines.
  • Fee appendices: attach internet and AV labor rate cards to the contract to avoid late surprises.

4) Partner success angles planners can replicate (how the planner shines, the DMC de-risks)

These are not claims about specific past events at named hotels. They are execution patterns that work in Hanoi and can be safely used as internal case angles or proposal logic. The objective is to show that your plan is built for control, not hope.

Angle 1: 950-theater summit at JW with overflow stream at NCC

What you sell internally: scale without single-point failure. JW hosts the core plenary within a verified capacity envelope; NCC provides overflow capacity and/or expo expansion.

What you standardize operationally: unified badge access, shuttle loops with timed waves, and instant schedule broadcasting via app + SMS fallback. Outcome: schedule stability even if a session room changes.

Angle 2: 700-banquet awards night with high-production stage build

What you sell internally: a banquet capacity that remains credible after staging, camera platforms, and aisle plans are included.

What you standardize operationally: a protected 4-6 hour setup buffer, rehearsal sign-off checkpoints, and a documented cue-to-cue run sheet shared with venue and AV.

Angle 3: Hybrid leadership forum with remote keynote reliability

What you sell internally: hybrid that is operationally governed. Remote speakers are integrated through tested connectivity and a planned rehearsal, not improvised on show day.

What you standardize operationally: dedicated bandwidth planning, wired connections at stage/FOH, backup network options, and a defined incident response path.

DMC deliverables that create planner wins (white-label, single accountability)

  • Single accountable ops lead: one owner across transfers, venue milestones, and supplier timelines.
  • Supplier consolidation: AV, transport, staffing, print, and contingency resources aligned under one operational governance model.
  • Bilingual on-ground command center: reduces translation risk during time-critical changes.
  • Run-of-show governance: time-stamped run sheets, checkpoint sign-offs, and escalation paths.

Client reporting metrics (proposal-ready): define success in measurable terms. Below is a basic metric set that works across corporate and association clients.

Metric Why it matters How it is captured
On-time start rate (sessions) Protects stakeholder confidence and speaker cadence Run sheet time stamps + stage manager logs
Check-in throughput (pax/min) Prevents congestion and late plenary entry Badge printing/check-in dashboard
Incident closure time Shows operational control under pressure Service recovery log with time stamps
Budget variance (final vs approved) Prevents late financial surprises Live budget tracker with approval workflow

If you want examples of how we structure partner outcomes and reporting, see partner success stories.

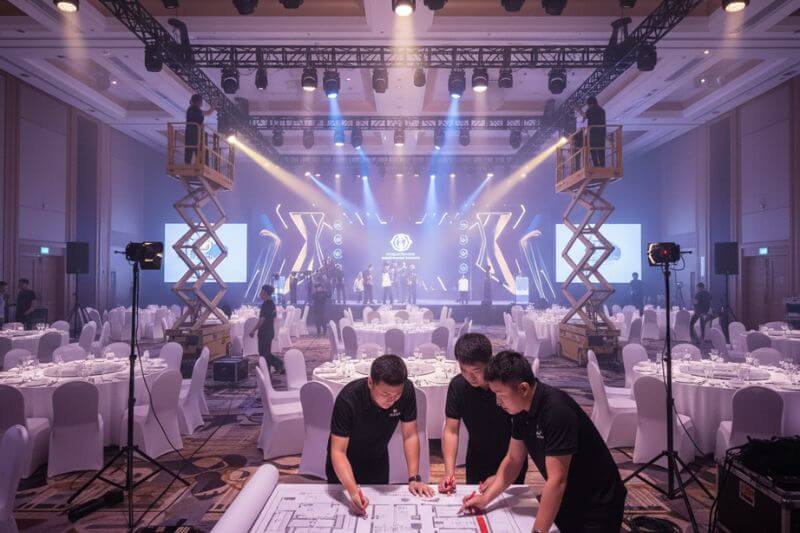

Gala dinner setup and lighting focus in progress with AV team and floor plan check for a 700-pax banquet configuration
High-production banquets succeed when rehearsal time, rigging approval, and seating resets are protected as non-negotiable milestones.

5) Tools and checklists for decision-stage sourcing (usable in proposals)

5.1 Venue due diligence checklist (Hanoi MICE venues capacity guide standard)

Use this checklist as an appendix in your stakeholder deck or client proposal. It demonstrates you are selecting venues based on execution certainty.

  • Capacities: verified pax-by-setup, including how staging affects numbers.
  • Room specs: sqm, ceiling height, pillar locations, door widths.
  • Pre-function: foyer sqm, registration feasibility, sponsor pod zoning.
  • Loading: dock dimensions, freight elevator size, route turns, storage policy.
  • Coach logistics: drop-off sequence, parking count, holding plan.
  • AV: rigging points, power distribution, outside AV policy, overtime model.
  • Internet: tier pricing, SLA for dedicated bandwidth, wired options at stage/FOH.
  • Rehearsal: protected time blocks and sign-off checkpoints.
  • Security: access control points, VIP routing, emergency response briefing.
  • Commercial: rate card appendices, attrition/cancellation clarity, uplift assumptions for peak windows.

5.2 RFP template outline for Lotte and Melia (closing the verification gap)

If you need to keep Lotte and Melia in play without exposing your proposal to unknowns, request a structured package with deadlines.

RFP attachments requested:

  • Room diagrams with measurements and ceiling heights
  • Pre-function diagrams with sqm
  • Loading dock and freight elevator photos with dimensions
  • Sample BEO draft timeline and revision policy
  • AV rate card + internet rate card (including dedicated bandwidth options)

Operational deadlines requested:

  • Capacity confirmation within 3-5 business days
  • AV rider review response within 5-7 business days
  • Technical rehearsal slot confirmation at contracting stage

5.3 Run-sheet framework (where buffer time is mandatory)

A run sheet is your schedule insurance policy. The framework below highlights where planners typically under-allocate time.

  • Registration opens: include buffer for walk-ins and badge reprints.
  • Ballroom doors: open earlier than start time to absorb late arrivals.
  • Session changeovers: allocate corridor clearance time before next seating wave.
  • Meals: include travel time to function space, not only dining duration.
  • VIP movements: separate timing and routes from general delegates.
  • Teardown: schedule load-out windows that do not block hotel operations.

5.4 Budget control sheet structure (prevent late overruns)

Use a structure that separates fixed commitments from variable exposure and enforces approvals.

  • Fixed costs: venue rental, contracted F&B minimums, base AV package (if fixed).
  • Variable costs: bandwidth upgrades, additional technicians, overtime, last-minute print/signage.
  • Contingency: +10% guideline on AV/internet until confirmed appendices are signed.
  • Approval gates: who approves changes and within what SLA.
  • Peak assumptions: Q4 uplift scenarios documented as planning assumptions until final quote.

For planners running multi-supplier operations, centralized visibility reduces risk. This is a core reason partners use Dong DMC: why partners choose Dong DMC.

Frequently Asked Questions

Q: What is the verified max capacity at JW Marriott Hanoi for theater and banquet setups?

A: For the Grand Ballroom (1,000 sqm, 7m ceiling), published capacities cite 950 theater and 700 banquet, with 540 classroom. For the Fansipan Ballroom (480 sqm, 7m), published capacities cite 450 theater and 300 banquet. Confirm final numbers in your BEO draft based on stage size, aisles, and camera platforms.

Q: How much setup time should we allocate for a ballroom with LED wall and rigging?

A: Plan 4-6 hours for a high-production ballroom setup at JW Marriott Hanoi. This buffer typically covers rigging/truss, stage build, LED wall setup, audio line checks, lighting focus, and seating reset with safety sign-off.

Q: Can JW Marriott support overflow or hybrid with NCC, and how does routing work?

A: Yes, pairing JW with National Convention Center (NCC) is a practical model for plenary overflow, expo expansion, or multi-stream congress formats. Operationally, it requires a timed shuttle loop, unified badge access with scan points, and instant schedule broadcasting (app push plus SMS fallback) so room or timing changes reach all attendees.

Q: What should we demand from Lotte Hanoi and Melia Hanoi before confirming for 2026 programs?

A: Written pax-by-setup tables, ceiling height, rigging points map and load limits, loading dock and freight route dimensions, coach parking count, foyer/pre-function sqm, internet tiers with SLA, and AV policy (in-house exclusivity vs outside vendor permitted). Without these, do not finalize program flow or production design.

Q: What are the common hidden costs (Wi-Fi/AV/tech labor), and how do we cap them?

A: The most common late additions are dedicated bandwidth, additional technicians, rigging approvals, and overtime. Cap them by requiring AV and internet rate cards as contractual appendices, using approval gates for variable lines, and holding a +10% contingency on AV/internet until the final bandwidth and labor plan is signed off.

Sources and freshness (what is verified vs what requires RFP confirmation)

Verified in trade sources (JW Marriott Hanoi): meeting space inventory, capacities by setup for key rooms, and general AV capability statements (internet availability often fee-based). Market context references also cite NCC as a large-scale alternative option for Hanoi.

Not reliably verified in current public sources (Lotte Hotel Hanoi, Melia Hanoi): complete pax-by-setup tables, ceiling heights, loading dock dimensions, coach parking counts, and detailed AV rate cards. For 2026 decision-stage planning, treat these as RFP-required and request diagrams plus written confirmations.

Freshness note: much of the accessible trade data is 2023-2025. For 2026 contracting, validate final capacities, policies, and pricing directly with the venue via RFP, and include AV and internet appendices in the contract to avoid ambiguity.

For additional Hanoi venue and routing context, see Hanoi MICE venues and Hanoi routing playbook.

Request Routing Advisory (Hanoi 200-1,000 pax)

If you are deciding between JW Marriott Hanoi, Lotte Hanoi, and Melia Hanoi for a 2026 program, request a Routing Advisory. We will validate the operational feasibility before you commit - including capacity math assumptions (with staging), coach routing, load-in windows, internet requirements, and a contingency model (NCC overflow or hybrid fallback).

Deliverables available on request: venue validation pack (capacity confirmation framework), AV checklist, draft run-sheet skeleton, and transfer routing plan aligned to your flight wave.

 |  Contact Our Team

Meet Our Founder: A Visionary with 20+ Years in Travel Innovation

At the heart of Dong DMC is Mr. Dong Hoang Thinh, a seasoned entrepreneur with 20+ years of experience crafting standout journeys across Vietnam and Southeast Asia. As founder, his mission is to empower global travel professionals with dependable, high-quality, and locally rooted DMC services. From humble beginnings to becoming one of Vietnam’s most trusted inbound partners, Mr. Thinh leads with passion, precision, and insight into what international agencies truly need. His vision shapes every tour we run— and every story we share.

Leave a Reply
Recent posts
Hanoi MICE Venue Capacity Guide for Planners (2026)
Hanoi MICE Venue Capacity Guide for Planners (2026)
Hoang Thinh Dong - 07/01/2026
Vietnam Group Airport Arrivals for Travel Agents | SOP
Vietnam Group Airport Arrivals for Travel Agents | SOP
Hoang Thinh Dong - 30/12/2025
Hanoi MICE Venues Playbook | Venue Selection & Execution Guide
Hanoi MICE Venues Playbook | Venue Selection & Execution Guide
Hoang Thinh Dong - 24/12/2025
