Hanoi political events can trigger strict, temporary road bans that operate more like a security protocol than normal congestion. For MICE programs, this changes transfer math, venue access windows, supplier delivery timing, and speaker readiness. This guide to Vietnam traffic protocol political events helps you keep program control with a permit-ready routing plan, realistic buffers, and a real-time communications and accountability layer you can show to clients and internal stakeholders.

If your venue is in Tu Liem (National Convention Center, My Dinh area), treat restriction days as a separate operating mode. For broader Hanoi routing baselines (non-protocol days), align your plan with our Hanoi group routing playbook and our risk overview in traffic and protocol risks.

Dong DMC transport captain briefing drivers on restricted-day routing, backup routes, and convoy yield protocol in Hanoi
Operational focus for political-event days: one routing owner, two pre-approved route options, and a documented cutover trigger.

Planning Takeaways

  • Plan closures as a security protocol, not “traffic.” - Hanoi can ban coaches (16+ seats) and trucks (1.5+ tons) from key roads for 4-10 hours per day during national-level events, especially near Tu Liem venues.
  • Build 120-180 minute buffers for high-stakes moves into Tu Liem. - Noi Bai to Tu Liem can add +45-90 minutes in practice, and convoy stops or unannounced extensions can add more.
  • Permits are a mitigation, not a guarantee. - Submit data packages 7-10 days prior, but design a plan that still works if exemptions are denied.
  • Use a real-time command layer to protect client perception. - Live vehicle ETAs, attendee check-in, push updates, and an incident log prevent “loss of control” narratives and make schedule changes provable and auditable.

1) Planner context and market insight for Vietnam traffic protocol political events

In Hanoi, political-event traffic protocol is a temporary operating regime implemented by authorities to prioritize security movements, rehearsals, and official delegations. It can include full or partial bans on vehicle classes on named roads, mandatory yielding rules for convoys (pull right, stop fully), and perimeter control around venues. This is structurally different from “normal” Hanoi congestion because access can be denied regardless of time spent in traffic or route optimization tools.

From recent official announcements picked up by VietnamNet and VietnamPlus, restriction patterns commonly include:

4-10 hours/day restrictions 1-3 day duration clustered Q4-Q1 Tu Liem hotspot

Tu Liem is repeatedly impacted because it hosts major national venues and event sites (e.g., My Dinh area and National Convention Center precinct). When roads such as Le Duc Tho, Le Quang Dao, and Pham Hung are restricted, the effect cascades across group routing, parking behaviors, and loading/unloading availability. Planners should assume that standard “city transfer times” are invalid during these windows and must be replaced with protocol-day routing assumptions.

Stakeholder impact map (what actually gets disrupted)

Airport transfers (Noi Bai to Tu Liem): expect time variability and forced reroutes. For tight arrival waves, a single restriction window can break check-in cadence, speaker prep timing, and pre-function catering release schedules.

Venue access windows: arrival is no longer “anytime.” You need controlled dispatch and a defined arrival slot architecture (waves), otherwise coaches stack in non-permitted areas and risk being turned away.

Supplier deliveries (AV/staging, heavy equipment): political-event days often ban trucks at or above 1.5 tons and may restrict 16+ seat vehicles on the same corridors. If your load-in depends on heavier trucks, assume delivery must happen earlier, via smaller vehicles, or via alternative access points coordinated with venue security and local authorities.

VIP movement risk: convoy priority can produce unplanned full stops of 30+ minutes. Without a documented fallback agenda block, this is where “schedule credibility” is lost in the room.

Commercially, the risk is not only late arrivals. The bigger exposure is client perception of control. If attendees receive conflicting instructions, if speakers do not know whether to start, or if the budget uplift appears “unexplained,” your agency absorbs reputational risk. The fix is controlled protocol operations plus a technology layer that makes movements measurable, accountable, and communicable in real time.

1.1 Who is most exposed (program types and group sizes)

The highest exposure in Hanoi is concentrated in three program profiles:

(1) Conferences and exhibitions at Tu Liem venues: especially where plenary start time is non-negotiable (broadcast windows, leadership openings, or multi-track sessions dependent on keynotes).

(2) Stadium-adjacent events and launches: where perimeters tighten and “Stand B vicinity” or designated areas can be controlled, limiting ad hoc arrivals and vendor access.

(3) City-based incentives with tight touring blocks: where morning city movements are stacked back-to-back and a single delay pushes the entire day.

Group size and vehicle type matter because restriction notices often specify bans on coaches (typically 16+ seats) and trucks. That disproportionately affects 50+ pax movements that rely on two or more coaches. When a coach cannot enter a corridor, the options become:

  • Split into smaller vehicles (vans/MPVs) for the restricted segment.
  • Stage outside the restricted polygon and “feed” by smaller vehicles or on-foot where viable.
  • Dispatch earlier and accept idle time inside an allowed holding zone.

1.2 What to monitor (decision signals 7-14 days out)

For proposal-stage risk control, we recommend a structured monitoring window from D-14 through Day-0. Updates originate from:

  • Hanoi Police announcements (often referenced by official and semi-official channels, including hanoitrafficpolice.vn).
  • VietnamNet and VietnamPlus coverage that republishes restriction details (roads, windows, vehicle classes).

Use “go / modify / relocate” triggers that are easy to defend to procurement and stakeholders:

  • Go if restriction windows do not overlap with plenary start, gala call time, or peak arrival waves, and your Plan B routing adds no more than 60-90 minutes.
  • Modify if restrictions overlap with one critical block but you can re-architect run sheet (arrival waves, two-step transfers, earlier load-in, hybrid content, or alternate staging).
  • Relocate if your critical blocks sit inside restricted windows and your program cannot tolerate a 120-180 minute buffer without harming content, compliance, or attendee experience.

Client-facing positioning you can use: “Hanoi remains viable during national events when routing is treated as a protocol operation. We will operate with a restricted-day dispatch plan (route A/B), pre-submitted permit package where applicable, and a live attendee and vehicle dashboard so schedule changes reach everyone within minutes.”

This reduces perceived risk because it describes process controls, not optimism.


2) Practical planning guidance for Tu Liem closures (venues, run sheets, routing, and tools)

If your meeting footprint includes My Dinh or the National Convention Center precinct, your plan should assume temporary closure of a set of key connectors (commonly Le Duc Tho, Le Quang Dao, Pham Hung, and surrounding segments) and apply “perimeter thinking”: you will not be optimizing the fastest route, you will be choosing the most reliable permitted approach with a controlled arrival choreography.

Recent notices have specified that trucks at or above 1.5 tons and coaches of 16+ seats may be restricted on affected routes during specific windows. That implies that large-scale MICE routing needs to be designed around vehicle class constraints, not just distance.

Venue-area planning reality (Tu Liem perimeter)

For Tu Liem venues, treat access as three layers:

  • Outer approach: major highways and ring roads (where reroutes are possible but travel time swings).
  • Perimeter roads: named streets that may be listed in restriction notices (where vehicle classes can be denied entry).
  • Final 300-800m: curb access, bay assignments, and “no parking” enforcement that can change day-by-day.

Your run sheet should include explicit instructions for where coaches can wait if they cannot curb-load. If you do not define a holding strategy, vehicles will idle in non-permitted areas and become vulnerable to being diverted by enforcement, creating unpredictable attendee drop-offs.

Bay assignment board for multi-coach arrivals with time slots and delegation labels for a Tu Liem venue
A visible bay plan reduces curbside confusion when no-parking rules tighten during protocol days.

2.1 Venue access strategy for Tu Liem (My Dinh and National Convention Center precinct)

Arrival choreography (conference model): plan staggered arrival slots by delegation, not “one big wave.” For 200-300 pax, assign 10-15 minute slots per vehicle and a controlled unload time (e.g., 6 minutes coach door-open to door-close). This prevents curb stacking when access compresses.

Offsite holding areas: define at least one offsite holding point outside the restricted polygon. If access tightens, you can hold coaches legally and feed attendees by smaller vehicles or re-time arrivals without losing accountability.

Feeder and walk-in options: if 16+ seat vehicles are restricted, deploy vans/MPVs as “feeders” for the final segment. The decision to walk-in must be based on safety, sidewalks, weather, and group profile. For proposal documents, phrase this as “last-mile contingency” rather than “walking plan.”

Loading/unloading constraints: assume temporary suspension of curb access and stricter no-parking enforcement. Pre-assign drop zones by delegation and define a maximum dwell time per vehicle. Your transport captain should enforce this with a stopwatch, not best intentions.

2.2 Sample run-sheet blocks that reduce failure points

Use run-sheet architecture that isolates risk. These blocks are designed to be copy-pasted into client proposals and internal ops run sheets.

Block A: Safer timing windows vs. red-zone windows

When restriction days are announced, they often include windows such as 06:00-13:00 and/or 13:30-23:00 (varies by event). Treat these as red-zone movement periods for Tu Liem approaches.

  • Green window concept: schedule critical plenary starts and speaker calls outside the published restriction windows whenever possible.
  • Red window concept: during restriction windows, program on-property items (hotel-based check-in, rehearsals, breakouts that do not require mass transfers).

Block B: Two-step transfer design (protects check-in and attendance)

  • Step 1: Airport - hotel transfer in an unrestricted window or on routes less exposed than Tu Liem perimeter roads.
  • Step 2: Hotel - venue dispatch using controlled release times, smaller feeder vehicles if needed, and a defined “late attendee” process.
  • Why this works: you protect room key distribution, badge issuance, and attendee comms before exposure to venue perimeter uncertainty.

Block C: Group split logic (designed for 16+ seat coach impacts)

  • Option 1: Two coaches dispatched 20-30 minutes apart with separate arrival slots, reducing curb clustering and exposure to a single enforcement action.
  • Option 2: Mixed fleet: one coach for equipment and non-restricted segments, vans/MPVs for last-mile delivery into the perimeter.
  • Option 3: Delegation segmentation (speakers/VIPs/crew) on a protected route and earlier dispatch, attendees on standard route with larger buffer.

2.3 Planning tools MICE teams can reuse (works for clients and internal control)

These tools reduce rework, support approvals, and create audit trails when schedules change.

(1) Restriction-day routing worksheet (proposal-ready fields):

  • Program date(s), restriction risk level (D-14 preliminary, D-7 confirmed, Day-0 live)
  • Venue name and access side (north/south entry if applicable)
  • Pax count per movement wave
  • Vehicle type and seat count (flag 16+ seat vehicles)
  • Vehicle plates (for permit submission if required)
  • Route A and Route B (named roads included)
  • Dispatch time, latest depart time (hard gate), expected buffer (in minutes)
  • Decision owner and escalation contact

(2) Comms matrix (reduces “loss of control”):

  • Attendees: meeting point, time window, shuttle bay changes, delay notices, multilingual templates
  • Speakers: revised call time, stage rehearsal slot, green room readiness confirmation
  • Venue: bay plan, security contact, delivery window reconfirmation
  • Transport lead: live cutover triggers, convoy stop protocol reminders
  • Client stakeholders: dashboard link, situation updates at a fixed interval, decision log

(3) Dashboard essentials (planner-centric control):

  • Live vehicle ETAs: per vehicle, per route, with threshold alerts (e.g., ETA slip > 15 minutes)
  • Attendee check-in %: hotel muster and venue entry using QR/badge scans
  • Session delay flags: if speaker movement is impacted
  • Budget burn vs. plan: restriction-day premiums tracked separately (escort hours, overtime, additional vans)
  • Supplier confirmation automation: time-stamped confirmations for transport, venue access, and delivery slots

For partners who want a dedicated platform layer for quoting, confirmations, and live ops, see the Dong DMC Agent App. We use it to keep a single source of truth across multi-supplier operations and to maintain an audit trail for client reporting.


3) Operational excellence and risk management (how to run it smoothly on the ground)

A workable plan for Vietnam traffic protocol political events has two characteristics: it is permit-ready (you can apply for exemptions where possible), and it is permit-independent (it still executes if exemptions are denied or restrictions extend). The goal is not to predict the exact closure outcome. The goal is to control how your program behaves under uncertainty.

Step-by-step execution sequence (restriction-mode operations)

Step 1 - D-14 to D-7: monitoring and preliminary routing. Track official updates (Hanoi Police channels) and reputable pickups (VietnamNet/VietnamPlus). Build Route A/Route B with a defined staging point outside the restricted polygon.

Step 2 - D-10 internal deadline: permit package readiness. Lock the vehicle roster and key movement windows early enough to submit data without last-minute changes.

Step 3 - D-7 to D-3: submit coach details for clearance where applicable. Provide plates, seat count, route, timing, and supporting letters. Processing often takes 3-5 days and approvals are not guaranteed.

Step 4 - D-2: physical route reconnaissance. Do a test run 48 hours prior to identify choke points, turning constraints for coaches, and any newly installed barricades.

Step 5 - Day-0: controlled dispatch with hard gates. Operate with a transport captain, live ETA tracking, and a cutover rule to Route B when thresholds are met (example thresholds below).

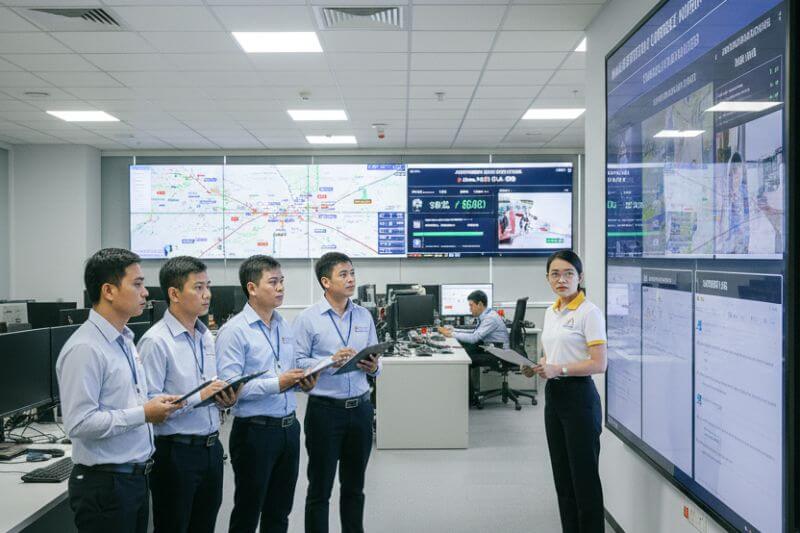

Dong DMC command center monitoring live vehicle ETAs, attendee check-in status, and incident log during a Hanoi restricted-day conference movement
Protocol-day standard: one decision-maker, one log, one set of outbound instructions across all stakeholders.

3.1 Permit and compliance workflow (no-surprise execution)

Permits (or exemptions) are constrained and context-specific. Treat them as a risk reducer, not a dependency. When notices specify restrictions on coaches (16+ seats) and heavier trucks (1.5+ tons), assume your default is “not permitted” until confirmed.

Data package checklist (submit-ready):

  • Vehicle plate numbers, vehicle type, seat count (flag 16+ seats)
  • Movement purpose statement (conference transfer, official meeting, etc.)
  • High-level pax manifest summary (not necessarily names in a proposal context, but count by delegation)
  • Routes with named roads and time windows (Route A and Route B)
  • Venue letter / confirmation of event and expected arrival windows
  • Operational contact list (transport captain, security liaison, venue contact)

Internal discipline that prevents permit failure: freeze vehicle roster changes after D-10 and manage attendee changes without changing the fleet unless absolutely required. When plates change last minute, permit processing resets or becomes invalid depending on the event’s controls.

Compliance briefing for drivers and escorts:

  • Mandatory yielding to convoys - pull right and stop fully when instructed
  • No improvisation onto restricted roads “to save time”
  • Only the transport captain can authorize route changes
  • Define a radio/phone escalation phrase for “access denied” situations

3.2 Routing and dispatch operations (what your ops team must physically do)

Restriction-day routing should be described in your ops file as “approved approaches” rather than “fastest route.” Recent routing suggestions included diversions such as:

  • Route family 1: National Highway 32 - Xuan Phuong - Provincial Road 70 - Thang Long Avenue (often adds 30-45 minutes depending on time and enforcement points)
  • Route family 2: Ho Tung Mau - Pham Hung - Me Tri - Chau Van Liem (viability depends on which segments are listed in restrictions that day)

Buffer assumptions that are defensible in client documents:

  • Noi Bai to Tu Liem on restriction days: plan +45-90 minutes additional travel time potential, with a 120-180 minute buffer for high-stakes plenary movements.
  • Convoy stop risk: plan for one unplanned stop that can exceed 30 minutes during high-security windows.
  • Unannounced extension risk: incorporate a 20% timing float across the day’s movement blocks (do not hide it - document it as contingency).

Recon/test-run protocol (D-2):

  • Drive Route A and Route B with a vehicle class similar to event day where possible
  • Mark realistic coach turning points and U-turn feasibility
  • Identify safe holding points (legal waiting zones) outside the restricted polygon
  • Confirm venue bay access and any new barricade patterns

Dispatch rules (simple, enforceable, auditable):

  • Hard gate: latest depart time is a rule, not a preference
  • Cutover trigger: if ETA slip exceeds 15 minutes or access is denied at a checkpoint, transport captain activates Route B
  • Wave discipline: vehicles only release by assigned wave to protect curb access
  • Escorts for 50+ pax: deploy 2-3 escort vehicles to manage last-mile decisions, bay communication, and attendee guidance

For broader coach behavior and curbside control standards across Vietnam group hotels and venues, reference our hotel access and coach logistics playbook.

3.3 Real-time visibility and comms (designed around planner fears)

On protocol days, the operational goal is not “no delays.” The goal is no unknowns. That means you should be able to answer, within minutes:

  • Where is each vehicle right now?
  • How many attendees have checked in at hotel muster?
  • How many have entered the venue?
  • Who is missing, and what is the next instruction they received?
  • What incremental cost has been approved due to restrictions (and by whom)?

Attendee tracking workflow (group accountability):

  • Hotel muster scan: QR/badge scan when attendees arrive to staging area (creates a “ready to move” list)
  • Vehicle assignment scan: optional secondary scan if you split into multiple vehicles/routes
  • Venue entry scan: confirms who arrived and allows “late arrivals protocol” without guesswork

Schedule broadcasting workflow (change reaches everyone):

  • Use push notifications (app), WhatsApp broadcast, and/or SMS for redundancy
  • Pre-build multilingual templates: “Bay change,” “Delayed departure,” “Session start moved,” “New meeting point”
  • Define an update interval (e.g., every 15 minutes during red-zone windows)

Command center SOP (single accountability):

  • One decision-maker: transport captain or ops lead authorizes route changes and release times
  • One incident log: time-stamped entries for access denial, convoy stops, and closure extensions
  • One outbound voice: all attendee instructions come from one channel owner to prevent message collisions

Budget controls (prevents late surprises):

  • Set an approval workflow for extra escort hours, overtime, and additional vehicles
  • Track “restriction-day premium” as separate line items so the post-event report is defensible
  • Close the loop with automated supplier confirmation time stamps

3.4 Risk register (what commonly goes wrong and how to neutralize it)

Risk 1: Unannounced restriction extensions (10-20% historical behavior). Mitigation: design agenda blocks with built-in float (20%), move non-critical content into red-zone hours, and keep plenary start outside published windows when possible.

Risk 2: Convoy stops creating unpredictable gaps. Mitigation: wave dispatch with escorts, and a “speaker protection movement” that departs earlier on the more reliable route. Keep speaker prep and technical checks protected by earlier call times.

Risk 3: Supplier delivery failures for heavy trucks (1.5+ tons). Mitigation: assume bans, advance delivery to D-1 or early Day-0 outside restriction windows, shift to smaller vehicles for last-mile, and confirm bay access with venue plus police liaison.

Risk 4: Weather compounding (Q1 cold and rain). Mitigation: sheltered muster points, covered feeder loading, and reduced walking dependency. If considering a city shift, note Da Nang’s flood exposure in Oct-Dec and evaluate based on your dates rather than preference.

Risk 5: “Unknown attendee status” during fragmented transfers. Mitigation: mandatory muster scan plus venue entry scan, and a clear late-attendee protocol (hold room, reroute, or remote join) for critical sessions.


4) Partner success angles (how agencies look good, while the DMC operationalizes)

When your client asks, “Can you still deliver Hanoi during national events?” the most credible answer is not a promise. It is a controlled operating model with measurable proof points. Below are proposal-safe case angles you can use to show competence without overclaiming.

Outcomes clients care about (and how to evidence them)

Outcome: “Zero late plenary start despite road bans.”
Evidence: restriction notice window vs. actual attendee arrival curve, wave dispatch logs, and speaker call-time adherence.

Outcome: “100% attendee accountability.”
Evidence: hotel muster scan report, vehicle assignment list, venue entry reconciliation, and exceptions list (who was late, why, resolution time).

Outcome: “Budget variance controlled.”
Evidence: restriction-day premium tracked separately, approvals time-stamped, and final reconciliation by category (escorts, overtime, additional vans, recon).

Role clarity (agency controls vs. DMC controls)

Agency control: client approvals, stakeholder expectation management, agenda priorities, speaker management, and escalation decisions (e.g., delay session vs. proceed).

Dong DMC control: permit data packaging, police liaison coordination, route reconnaissance, dispatch discipline, escort deployment, attendee tracking workflow setup, and incident logging with time stamps.

For references and execution patterns across complex groups, review partner success stories to see how we document operations and results in a client-forwardable way.

4.1 Case blueprint (proposal-ready): 300 pax conference in Tu Liem during restriction days

Movement design:

  • Wave arrivals from hotels: 6-8 waves depending on fleet and venue bay limits
  • Split fleet strategy: coaches for non-restricted legs, vans/MPVs as last-mile contingency if 16+ seats face access limits
  • Escort positioning: 2-3 escort units managing bay communication, reroutes, and attendee guidance
  • Muster points: covered staging area with QR/badge scanning, water, and clear signage
  • Agenda contingency blocks: buffer-coded segments and a “hold content” block ready to absorb delays without public disruption

Comms artifacts (what to capture for client report):

  • Dashboard screenshots: ETAs and check-in % at set timestamps
  • Push notification log: messages sent, time stamps, and language versions
  • Incident log extract: access denial, convoy stop, closure extension, and mitigation actions

Client-facing outcomes (how to write it): “All plenary sessions started within the accepted tolerance window. Attendee accountability was maintained via muster and venue entry scans. Restriction-day premium costs were pre-approved and reconciled with time-stamped supplier confirmations.”

4.2 Incentive add-on blueprint (low-risk programming during red-zone hours)

If you must program in a restriction window, use activities that do not depend on mass transfers:

  • Hotel-based activations: leadership meet-and-greet, product showcase, small breakouts, or internal awards
  • On-property CSR: pack builds, education kits, or locally sourced initiatives that can be staged at the hotel
  • Curated dining on-property: controlled start times, flexible seating waves, and less exposure to venue perimeter shifts

After restrictions release (often late afternoon/evening), schedule your “release valve” programming with flexible start windows and staged departures rather than a single fixed pickup time.


5) Checklists, templates, and SOP pack (planner-ready for Vietnam DMC operations)

This section is designed to be copied into internal planning docs or appended to client proposals as “Operational Controls.” It reduces approval friction and makes your plan auditable.

Restriction-day checklist (D-120 to Day-0)

D-120 to D-90 (program architecture):

  • Select venue and hotels with staging space suitable for muster and wave dispatch
  • Build agenda with buffer-coded blocks (identify “movable” segments vs. “fixed” segments)
  • Define your command center model: decision owner, update interval, channels

D-30 (data readiness):

  • Draft routing worksheet with Route A/Route B
  • Confirm vehicle class plan (how many 16+ seat vehicles, how many vans/MPVs)
  • Define supplier delivery plan for AV/staging (assume truck restrictions and plan earlier delivery)

D-14 (monitoring cadence begins):

  • Start daily monitoring of official restriction notices and credible pickups
  • Run a feasibility check: do published windows collide with critical blocks?
  • Prepare client-facing contingency statement (process + buffer + comms)

D-10 (freeze operational data package):

  • Freeze vehicle roster version (plates, seat counts)
  • Freeze attendee roster version for operational counts (names may still change, but counts per wave should not)
  • Lock permit submission package readiness

D-7 (permit submission and recon scheduling):

  • Submit clearance requests if applicable (processing often 3-5 days; no walk-in dependency)
  • Schedule D-2 route reconnaissance
  • Pre-build comms templates for potential bay changes and delays

D-2 (test run and final bay plan):

  • Execute Route A/Route B test runs and capture realistic travel times
  • Confirm holding zones and coach turning points
  • Finalize arrival slot schedule by delegation

Day-0 (dispatch discipline):

  • Driver briefing: convoy yield rules, no improvisation, who authorizes route changes
  • Activate command center: live ETAs, attendee scans, incident log
  • Operate hard gates and cutover triggers

Tu Liem restriction-day run sheet template (copy/paste format)

Movement block: Hotel - Venue (Tu Liem)
Buffer rule: 120-180 minutes for critical blocks on restriction days
Dispatch model: Waves + escorts + hard gates

  • Wave 1: Speakers/VIPs - Depart [time] - Route A - Escort 1 - Venue Bay [X] - Latest depart [time]
  • Wave 2: Delegation A - Depart [time] - Route A - Escort 2 - Venue Bay [Y] - Latest depart [time]
  • Wave 3: Delegation B - Depart [time] - Route B (pre-authorized alternative) - Escort 3 - Venue Bay [Z] - Latest depart [time]
  • Cutover trigger: If ETA slip > 15 minutes OR access denied at checkpoint OR convoy stop extends > 10 minutes, transport captain activates Route B and issues an attendee update
  • Accountability points: hotel muster scan opens [time]; closes [time]. Venue entry scan opens [time]

Supplier confirmation automation (freeze points to prevent churn)

To prevent last-minute changes from multiplying risk, set freeze points:

  • Transport lock: freeze fleet and plates by D-10
  • Venue access reconfirmation: reconfirm bays and delivery windows at D-2 and again Day-0 morning
  • Attendee comms freeze: stop changing meeting points within 60-90 minutes of dispatch unless an incident trigger occurs

Post-event analytics template (client-ready reporting)

A protocol-day report should be short, numeric, and defensible:

  • Punctuality KPIs: planned vs. actual depart/arrive times per wave
  • Accountability KPIs: muster scan count, venue entry count, exceptions and resolutions
  • Incident log summary: category, time, duration, mitigation, outcome
  • Budget variance: restriction-day premiums separated and approved with audit trail
  • Prevention actions: what changes in the next Hanoi run sheet (route choice, wave sizing, earlier load-in)

If sustainability requirements are part of your corporate governance, align operational decisions with sustainable operations (e.g., minimizing idle time via better wave planning rather than adding unnecessary vehicles).


6) Frequently Asked Questions (proposal-safe answers for high-stakes decisions)

Q: How early do we need to plan permits for coaches, and what if approval is denied?

Plan your permit data package by D-10 and submit 7-10 days prior where applicable. Processing is commonly 3-5 days and approvals are not guaranteed. Your operational plan should still execute without permits by using (1) a split fleet (vans/MPVs for last-mile), (2) a staging point outside the restricted polygon, and (3) earlier dispatch with 120-180 minute buffers for critical blocks.

Q: Which roads and districts are typically restricted around My Dinh and Tu Liem venues?

Restriction notices frequently include Tu Liem connectors such as Le Duc Tho, Le Quang Dao, and Pham Hung, and can extend to segments feeding the My Dinh and National Convention Center precinct. The practical implication is that your final approach should be planned as “perimeter controlled,” with Route A/Route B and an offsite holding zone, not a single point-to-point route.

Q: How much buffer is realistic for Noi Bai to Tu Liem on restriction days?

For restriction days, assume +45-90 minutes can occur due to forced reroutes and convoy stops. For high-stakes moves (plenary, gala call time, speaker movements), plan a 120-180 minute buffer into the Tu Liem approach so your start time is protected even if access tightens.

Q: Can we still run 50-300 pax programs when 16+ seat coaches are impacted?

Yes, if you design movements around vehicle class constraints. Common solutions include wave dispatch (slot-based arrivals), mixed fleet (coaches for unrestricted legs plus vans/MPVs for last-mile), and a defined staging/holding plan outside the restricted polygon. Without these controls, large groups are exposed to access denial and curbside stacking.

Q: How do you maintain real-time attendee visibility when transfers fragment into multiple vehicles and routes?

Operate two scan points: hotel muster and venue entry. When transfers split, add optional vehicle assignment scans. This produces a live list of who is ready, who is moving (by vehicle), who arrived, and who needs intervention. Pair this with push/SMS updates on bay changes and revised timings so instructions remain consistent.

Q: What budget uplift should we forecast for escorts, recon, overtime, and tech-enabled command center operations?

Forecast a planning allowance for restriction days, typically driven by extra escort hours, route reconnaissance, and potential additional vehicles to avoid 16+ seat constraints on restricted segments. A practical working range many agencies use is a 10-20% uplift on transport and staffing-related lines for restriction-mode days, tracked as “restriction-day premium” for clean client reporting and approvals.


Request Routing Advisory for Hanoi Protocol Days (24-48 Hour Response)

Send your draft program grid and dates, and we will return a restriction-day feasibility check: Route A/Route B routing concept, buffer recommendations (by movement block), a permit pathway (if applicable), and a command-center comms and accountability model suitable for client proposals.

If you need a full costed solution, we quote in 12-60 minutes once your core parameters are confirmed. Brand-protected operations. Zero missed arrivals.

 |  Contact Dong DMC

What we need from you to issue a routing advisory

To keep your internal approvals clean and reduce iteration cycles, send these inputs in one message:

  • Dates and city footprint: include any Tu Liem venue days and rehearsal days
  • Venues and hotels: names, addresses, and preferred entry side if known
  • Group size and wave logic: total pax and expected peak movement waves
  • Fleet preference: coaches vs. vans/MPVs, accessibility needs, luggage loads
  • Flight waves: arrival/departure blocks and VIP movements
  • Critical fixed points: plenary start tolerance, gala call time, speaker rehearsal windows
  • Technology requirements: badge printing/check-in, attendee tracking, push messaging, budget approval workflow

Expectation setting for clients: we can guarantee process controls (monitoring, recon, dispatch discipline, comms, accountability). We cannot guarantee permit approvals or prevent last-minute authority changes. The objective is to make outcomes predictable and documentable even when rules shift.

Dong DMC airport arrival control desk verifying flight waves, assigning vehicles, and updating live attendee status for a corporate group in Hanoi
Protocol-day resilience starts at arrivals: flight wave control, vehicle assignment discipline, and live attendee status.

Operational proof resources (for your proposal appendix)

Use these links as supporting material when your client asks “how do you control execution risk in Vietnam?”


Meet Our Founder: A Visionary with 20+ Years in Travel Innovation

At the heart of Dong DMC is Mr. Dong Hoang Thinh, a seasoned entrepreneur with 20+ years of experience crafting standout journeys across Vietnam and Southeast Asia. As founder, his mission is to empower global travel professionals with dependable, high-quality, and locally rooted DMC services. From humble beginnings to becoming one of Vietnam’s most trusted inbound partners, Mr. Thinh leads with passion, precision, and insight into what international agencies truly need. His vision shapes every tour we run— and every story we share.

Leave a Reply
Recent posts
Hanoi Protocol-Day Transfers for MICE Planners | Risk Controls
Hanoi Protocol-Day Transfers for MICE Planners | Risk Controls
Hoang Thinh Dong - 02/01/2026
Vietnam Emergency Protocols for Groups | Corporate Planning
Vietnam Emergency Protocols for Groups | Corporate Planning
Hoang Thinh Dong - 01/01/2026
Vietnam Group Dining Planning Guide for Incentive Planners
Vietnam Group Dining Planning Guide for Incentive Planners
Hoang Thinh Dong - 01/01/2026
